A protection acceptance test needs an agreed limit, a controlled setup and a record tied to the amplifier being supplied. Producing an alarm or watching a trace change does not by itself show that the required protection worked. The RF response, recovery and post-test condition each need their own acceptance criteria.
For the 6–8 GHz 100 W CorelixRF module, write the test plan before selecting a mismatch fixture or applying fault exposure. The plan should distinguish ordinary functional checks from tests that deliberately present a non-matched load. Neither the article nor a generic protection feature list authorizes an unrestricted fault test.
Identify the DUT and resolve configuration-dependent limits
The source document is CRF-PA-6000M8000M-100W-M. Its June 2026 electrical table lists 6–8 GHz, 100 W minimum rated output, 50 dB minimum small-signal gain and 0 dBm maximum input. It identifies SMA-F input, N-F output, a 7W2 control interface, nominal DC 28 V and a 300 × 360 × 110 mm form factor.
Cooling is stated as dependent on the final design configuration. Obtain the actual mounting and cooling requirements, power interface and control definition before a powered test. Do not transfer an airflow assumption or pin table from another module. Use the 6–18 GHz microwave amplifier platforms page to compare the product family, then request the exact configuration and evidence required by this review.
The table places the ±2.5 dB gain-flatness entry in the minimum column, and describes input VSWR as 2:1 typical. Resolve any acceptance-limit ambiguity with the supplier; do not silently turn either entry into a guaranteed maximum. Input match is also separate from the allowable output-load exposure.

Build the acceptance matrix around separate questions
Organize the test by what each step can establish. A detector-input injection may check downstream logic without testing the RF sensing path. A low-power passive-load measurement characterizes the load path without proving high-power fault survival.
| Test stage | Conditions to bind | Evidence or criterion |
|---|---|---|
| Configuration review | Unit identity, revision, interface and cooling documents | Correct document set and agreed unresolved items. |
| Matched-load baseline | Required frequencies, waveform, drive, supply and thermal state | Defined power, gain, current and temperature criteria. |
| Functional alarm check | Approved signal or permitted operating condition | Expected alarm and RF state; scope of the check recorded. |

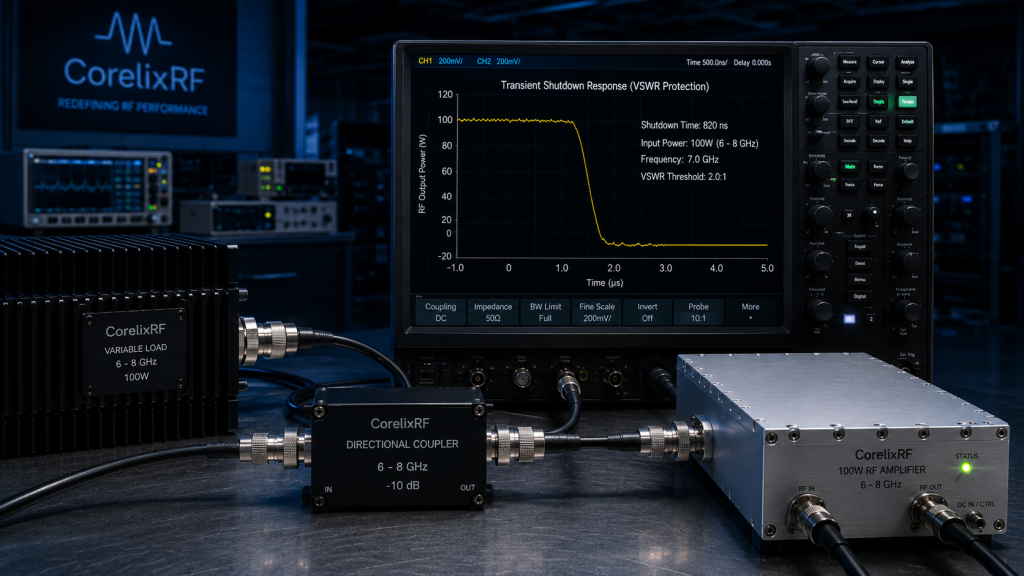

| Controlled load-fault test | Separately approved load, phase, duration and drive envelope | Defined RF response and permitted exposure, with stop conditions. |
| Recovery and post-test checks | Reset conditions and repeated baseline measurements | Agreed recovery state and allowed performance change. |
Record omissions explicitly. A required check that could not be run remains unverified; it does not become a pass because the other stages completed. Avoid a single “VSWR test passed” label covering several different questions.
Qualify the setup before exposing the module to a fault
Identify the load, coupler, sampling path, sensors, attenuators and instruments by part and rating. Check their applicable frequencies, main-line power, sampled levels and reverse-power exposure. Keep the input drive and supply limits visible in the procedure.
Calibrate or characterize the relevant reference planes before the powered sequence. Preserve the connection drawing and any correction data. Moving a cable or replacing a transition can change the setup; assess whether the prior calibration remains applicable.
Intentional mismatch testing requires a supplier-agreed envelope and suitably rated hardware. An arbitrary open termination behind an attenuator is not a universal approved load, and disconnecting an energized output is not a controlled test method.

Use measured RF behavior to judge a timing requirement
Where response time is specified, state the starting event, ending output criterion and allowed measurement uncertainty. Choose instruments and sensors that can resolve those events without excessive loading or saturation. Keep time alignment and path delays with the result.
A fault flag, controller log or gate-control transition can help explain a sequence, but the acceptance requirement may concern RF output. Preserve the signal needed to evaluate that requirement. If the setup measures only part of the path, label that limitation in the test record.
Thermal images and enclosure temperatures may support an investigation; they do not directly measure semiconductor junction temperature. Nor does a brief absence of visible heating prove absence of electrical stress or latent damage.

Close each criterion with a result or an open item
The report should bind the DUT and settings, test configuration, calibration, measured values, acceptance limits, anomalies, stop events and recovery behavior. Include the before/after performance checks required by the agreement. A successful restart is one observation, not the complete acceptance decision.
Use the RF front-end integration overview to identify any host or load responsibility outside the PA test. Compare RF amplifier configurations using their own document sets rather than assuming that one module’s result qualifies an entire family.
When a limit, setup or fault envelope remains undefined, keep that item open and specify the evidence needed to close it. This makes the test report useful to the buyer without fabricating completed factory testing.
Agree the test scope before the fault test
Send CorelixRF the 6–8 GHz 100 W protection acceptance matrix and required records.
